Energy · People's Republic of China
How much did Phase I of the Tianwan Nuclear Power Plant in China cost?

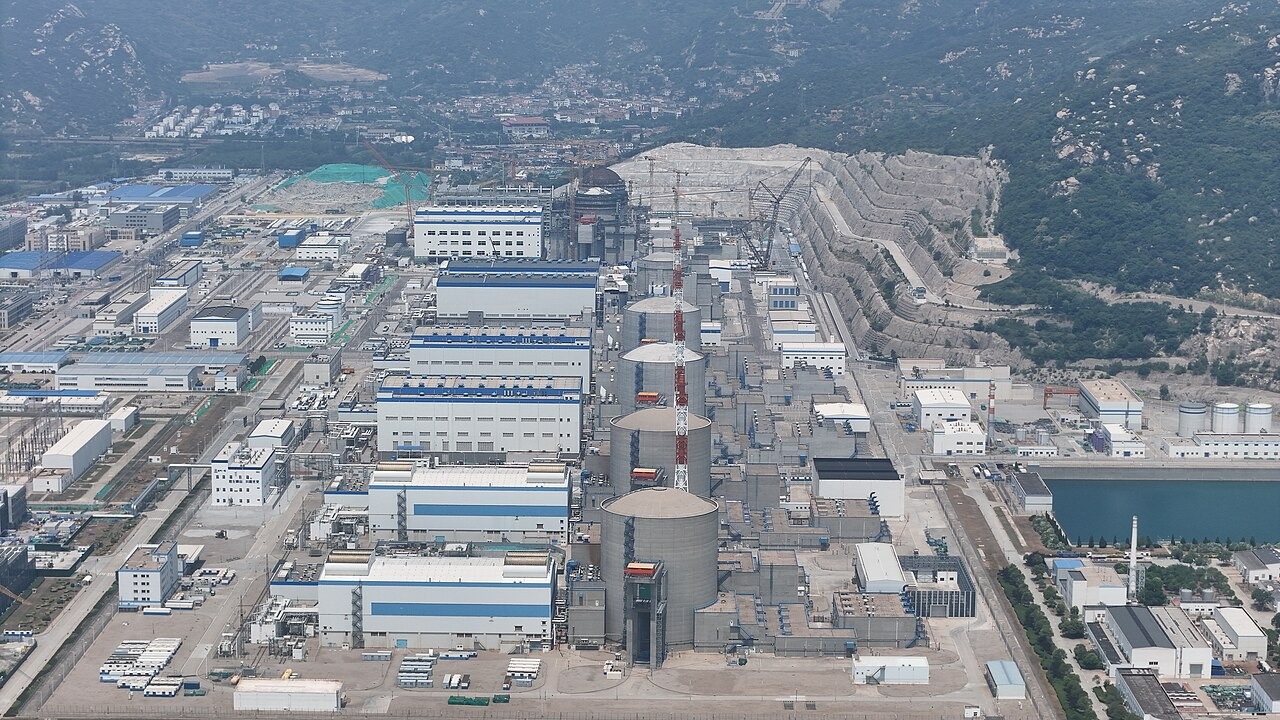

Tianwan Nuclear Power Plant in Lianyungang, Jiangsu, China, is a Chinese-Russian nuclear station built in phases with VVER reactors. Its Phase I, two VVER-1000/428 units of about 1,060 MW each, was built from 1999 to 2007 (91 months from first concrete to grid connection) and, according to the OECD Nuclear Energy Agency, was originally estimated at USD 2.5 billion but finally cost over USD 3.2 billion, USD 1.4 billion of it on the Russian side. Phase II (units 3 and 4, 2 x 1126 MW, 2012-2018) was estimated at USD 6.0 billion, and later VVER-1200 units are under construction.
Final project cost
$3.2 billion
Cost basis: 2007
Cost evidence
Basis of the published figure
Project metrics
Key dimensions
- PowerOECD Nuclear Energy Agency (case study, 2014 workshop)
- 2,120 MW
Project record
